A Loveland, CO–based investigation into homeless shelters, dark money, and the council.
Terms on this page

The urban-renewal plan, in one paragraph

The Centerra Urban Renewal Plan was adopted by Loveland City Council in 2004 and is scheduled to expire in 2029. It financed the master-planned community east of I-25 along U.S. 34 that has been developed by McWhinney Real Estate Services and its affiliated entities. The plan’s funding mechanism — described in a 2004 Master Financing Agreement (MFA) between the City, the Loveland Urban Renewal Authority (LURA), and Centerra’s metropolitan districts — allowed taxpayer-supported revenues collected inside the URA boundary to flow back to the developer’s metro districts to repay infrastructure bonds. Over the twenty-year life of the plan, more than one billion dollars in cashflows have moved through that channel1 .

The Master Financing Agreement (MFA) and Exhibit L

Exhibit L of the MFA contains the bidding rules: prequalification of vendors, selection of the lowest qualified bidder, formal abstracts of every bid received, and an audit trail confirming that bids were received before the posted deadline. These rules existed precisely because the entity awarding the contracts (Centerra Metropolitan District No. 1) and the entity often receiving them (McWhinney Real Estate Services and its related companies) shared overlapping leadership and ownership.

In February 2025, the LURA board engaged Ernst & Young to perform a forensic examination of how that channel had actually been operated. The engagement was approved alongside the cost of the Krenning recall election at the 16 December 2024 Council meeting — the same Council that the recall ultimately replaced2 .

Phase I findings, delivered 14 October 2025

E&Y’s Phase I team — partner Gary Burke, senior manager Chad Francis, and managing director Mark Russell — reviewed 5,587 files and 90,000 general-ledger transactions dating to 2009. They sampled 73 cash disbursements and 9 public bid awards (out of 46 public-bid projects available for sampling — $11.9M of $51.1M awarded since 2015). The engagement letter is dated 18 December 2024; fieldwork ran 12 February — 13 October 2025; the final report carries a 3 November 2025 cover letter. Original engagement budget was $249,000; at the 14 October LURA meeting partner Gary Burke confirmed under direct questioning by Commissioner Samson that the budget had been exceeded prior to delivery of the report3 .

Diagram of the three Ernst and Young audit finding categories. Bidding: $51.1 million publicly-bid testing universe 2015-2023; $6.2 million of project spend not subject to public bid but potentially-should-have-been depending on interpretation of Construction in the MFA; Exhibit L of the MFA not followed, prices revealed before evaluation, contracts to non-lowest bidders, bid abstract sheets unavailable. Disbursements: invoices coded to wrong GL accounts, missing approvals, payments in wrong financial periods, no monthly financial close. Related-party transactions: 4.9 million dollars to McWhinney Real Estate Services since 2009 for management/landscaping/marketing, water rights transferred from McWhinney entities to the district with no market-price analysis, metro district board members with employment or financial interests in McWhinney firms did not recuse, no formal arm's-length evaluation procedure exists.
FIG. 1 Ernst & Young Phase I findings as reported to the LURA board on 14 October 2025. Bidding scope: $51.1M publicly-bid testing universe 2015-2023, of which $6.2M (precise: $6,221,959, 30 transactions, 7.0% of project spend per Table 2) was identified as project spend not subject to public bid but potentially-should-have-been depending on the interpretation of 'Construction' in the MFA. The Phase II forensic-investigation scope is still under negotiation.

The bidding finding

The metro district developed its own internal practice of evaluating proposals only after the bid prices were revealed, which is the opposite of how Exhibit L specifies. The auditor’s quote, from the public minutes:

Public competitive bidding processes and the related controls are designed to ensure fair competition, transparency and accountability. They prevent perceived or actual favoritism, corruption and misuse of public funds. — Gary Burke, E&Y partner, to LURA board, 14 Oct 20253

E&Y reviewed payments between the metro district and McWhinney-affiliated entities including McWhinney Real Estate Services, Centerra Properties West, and Centerra Retail Sales Fee Corp. They identified $4.9 million in management, landscaping, and marketing fees paid to McWhinney Real Estate Services since 2009. Water rights for irrigation were transferred from McWhinney-related entities to the metro district without any written analysis of fair-market pricing. Metro district board members who had declared employment or financial interests in those firms did not recuse themselves from the related votes — and the district has no formal procedure to document whether such transactions are made at fair market value1 .

LURA board response

The board took no public action on the findings at the 14 October meeting. It recessed into executive session to consult legal counsel about the audit’s findings and potential next steps. Phase II — “deeper forensic investigation,” per Burke’s deliverable — has not yet been scoped or publicly funded.

At the 14 October Q&A multiple commissioners’ substantive questions were ruled by Chair Shadduck-McNally as “legal questions, cannot be answered” and deferred into the 9 December 2025 executive session — including (a) Olson’s question about whether 2004–2009 transactions were excluded by the statute of limitations, (b) Mallo’s question about “recourse” on the bid findings, (c) Light-Kovacs’s question about whether non-use of Exhibit L constitutes a compliance violation, and (d) Samson’s question about the materiality threshold for the audit. The Dec 9 LURA meeting itself was structured so that the only General Business items were “Executive Session” and “Action Following the Executive Session” — there was no public agenda item to discuss the report’s findings on the record.

The Centerra Phase I numbers, in one place

FigureSource line (Phase I)
$88.4M Project Spend, $39.6M Non-project Spend (Metro District GL 2009–2023)§3.1 Flow of Funds
$34.5M PIC → Centerra Properties West reimbursements (2008–2023)§3.1 Flow of Funds
$18.4M Metro District spend 2009–2014, scoped out of Phase I sampling§4 Procurement, recommendations
Sample tested: 9 of 46 projects, $11.9M of $51.1M of post-2015 public-bid awardsTable 1 + §4
37 contracts not in initial sample, EY recommends review§4 recommendation list
Board members with disclosed interests in McWhinney-affiliated firms did not recuse from related-party votes; “no board member recused themselves from related voting matters since the MFA’s inception”§6.1 Related Party Observations
0 documented arms-length evaluations of related-party transactions§6.1
Engagement letter signed18 Dec 2024
Fieldwork window12 Feb 2025 — 13 Oct 2025
Final report cover letter3 Nov 2025
Original budget$249,000 (publicly confirmed exceeded by 14 Oct)

The Centerra 2025–26 budget context

Aug 12 LURA presentation by CFO Brian Waldes places the audit findings against the URA’s ongoing cash flow. The audited entity is a $20–24M/year fund:

Centerra North (US34/Crossroads URA)2024 actual2025 adopted2025 revised2026 proposed
Revenues (sales-tax PIF + property-tax TIF)$20,241,394$24,027,165$24,027,165$22,661,880
Expenses (debt service dominates)$20,155,819$24,027,165$24,027,165$22,614,192
Operating ending balance$537,025 (Centerra portion)

URA sunset year is ~2030. Through-2030 projected sales-tax revenue is $182.1M total ($114.1M to the City of Loveland at 1.75¢; $68.0M to the URA at 1.25¢ of the 3¢ rate). The Development Planning & Financing Group’s March 2023 Cost-of-Service Study (Attachment 5 to the Aug 12 packet) reports that the “Centerra North Project Plan” contributes an estimated $3,720,029 to the City of Loveland General Fund each year — a figure the Mayor characterized at the Oct 14 LURA hearing as “flawed analysis in part due to it using a household income that is incorrect.”14.5

Directed graph of the Centerra urban-renewal stack showing four clusters: the developer side with Chad and Troy McWhinney as principals of Realberry Real Estate Services and Centerra Properties West and seven affiliated entities; the quasi-public metro district side with Centerra Metro District No. 1, its five-seat board, the Public Improvement Collection Corporation, and the Centerra Retail Sales Fee Corporation; the administrator side with Pinnacle Consulting Group, Bryan Newby as district manager, and Icenogle Seaver Pogue P.C. as district counsel; and the city and audit side with the City of Loveland, the LURA, Ernst and Young, and the 2004 Master Financing Agreement. Jeff Breidenbach is rendered as a red-bordered node bridging the metro district board and Realberry's NoCo Development Director role. The PIC-to-CPW edge is drawn in oxblood with a 34.5 million dollar untested-in-Phase-I label.
FIG. 2 The Centerra stack at a glance. Solid edges are corporate control or direct employment; dashed edges are service contracts or payment flows; dotted edges are governance overlaps. The red-bordered Breidenbach node is the documented dual role — Centerra Metropolitan District No. 1 board president and Realberry Northern Colorado Development Director. Ernst & Young’s 17 May 2026 finding that ‘no board member recused themselves from related voting matters since the MFA’s inception’ is the institutional context behind that single node.

Centerra Metropolitan District No. 1 — board roster and the recusal record

The five seats on the Centerra Metropolitan District No. 1 board as of the 19 February 2026 regular-meeting agenda are listed below. Two share employment, ownership, or business affiliation with Realberry (formerly McWhinney Real Estate Services) or its affiliated entities; one of those two is the board’s president.

SeatNameTerm endsOutside-role disclosure on record
PresidentJeff BreidenbachMay 2029Realberry “Director of Development, Northern Colorado” (per Reporter-Herald, 18 Feb 2026 coverage of the BAA approval)10
Vice PresidentDavid SpaethMay 2027
TreasurerSam VoelzMay 2029
SecretarySamantha SalazarMay 2029
Asst. SecretaryWendy MessingerMay 2027
Source: Centerra Metropolitan District No. 1 — 2026 Regular Meeting Agenda, 19 February 2026 (SDACO 32-1-809 transparency notice + per-district 2025 Annual Report) — local archive /docs/pdf/centerramd_CMD-2026-02-19_Regular_Meeting_Agenda.pdf

Every Centerra MD board agenda since the MFA was signed in 2004 has carried a standing Item I.B “Director Disclosure of any Potential Conflicts of Interest.” The Ernst & Young Phase I report describes, on the record, what that procedural box has produced:

Metro District board members submitted conflict of interest disclosures to the Colorado Secretary of State prior to board meetings and disclosed their employment with MRES and financial investments in developments located within the Metro District, and we understand no board member recused themselves from related voting matters since the MFA’s inception.11

The standard Record-of-Proceedings boilerplate the audit quotes immediately afterward gives the institutional reason: “the participation of the members present was necessary to obtain a quorum or otherwise enable the Boards to act.” A quorum that cannot be reached without conflicted members converts non-recusal from an individual choice into the district’s default operating mode.

The 15 January 2026 CMD No. 1 board meeting — three days after Articles of Amendment renaming McWhinney Real Estate Services to Realberry took effect — ratified twenty-three open work orders on consent. Item VIII of that same agenda recessed the board into executive session for “legal advice from general counsel related to financing for Parcel 504 public improvements” — the Business Assistance Agreement the council would publicly approve thirty-three days later. The 19 February meeting, forty-eight hours after the council’s 8-1 BAA vote, then approved a $559,050 Merrick Engineering proposal for Parcel 504 engineering-and-survey services and recessed into executive session for legal advice on the E&Y audit.12

Pinnacle Consulting Group — the district administrator

Centerra Metropolitan District No. 1 does not have its own staff. Day-to-day administration, accounting, district management, and capital-project oversight are performed under a long-running services contract by Pinnacle Consulting Group, Inc. — a Loveland-based district-services firm founded in 2004, the same year the Centerra MFA was signed. Pinnacle reports administering roughly 100 Title 32 special districts statewide, a $780 million bond-debt portfolio under management, and $80 million in capital projects.13 The Centerra metro districts account for roughly $232 million of that bond portfolio — about thirty percent of Pinnacle’s total book.

The recorded attendance at the 16 October 2025 CMD No. 1 board meeting included nine Pinnacle staff (Newby, Brown, Ortiz, Doug Campbell, Krause, Ondracek, Brendan Campbell, Jenkins, Downing) plus two McWhinney-company observers (Jim Niemczyk and Eric Robinson), Alan Pogue of Icenogle Seaver Pogue, P.C. (district counsel), and Jonathan Jacobson of Cohere — out of a typical thirteen-to-fifteen attendees. The board’s president was at the same meeting. The functional distinction between “board,” “administrator,” and “developer” was procedurally narrow in that room.14

Untested in Phase I: the $34.5 million PIC → CPW channel

Sankey diagram showing Centerra revenue cascading from property tax TIF and sales tax PIF into the Public Improvement Collection Corporation, which then splits into two outflows: the metro district side, marked tested, flowing to bondholders and to McWhinney Real Estate Services and to CPW direct and to the Centerra Retail Sales Fee Corporation; and the developer reimbursement side to Centerra Properties West labelled $34.5 million dollars not tested in Phase I, shown in oxblood with dashed strokes. A red-bordered callout reads Phase II scope question not yet authorized as of 17 May 2026.
FIG. 3 Cash flow as documented in Section 3.1 of the Ernst & Young Phase I deliverable. Property-tax TIF and PIF sales tax feed the PIC; from the PIC two paths leave. The Metro District side — debt service plus $4.9M to McWhinney Real Estate Services, $2.7M to CPW direct, $1.42M to the Retail Sales Fee Corporation — was tested. The PIC-to-CPW developer-reimbursement path of $34.5M (oxblood dashed) was identified through PIC check registers but scoped out of Phase I; its testing is the open Phase II question.

Section 3.1 of the E&Y deliverable — “Flow of Funds Analysis” — documents the cascade by which property-tax TIF and the 1.25¢ Public Improvement Fee sales-tax revenue collected inside the URA boundary travel from the city through the Centerra Public Improvement Collection Corporation (PIC) and onward. Two paths were tested in Phase I; one was not.

PIC → Metro District
Debt service on the ~$232M cumulative bond stack (Series 2017 $187.975M, Series 2018 $11.105M, Series 2020A $33.105M, Series 2022). Mill levies on Centerra residents range from 15.626 mills (District 5) to 46.756 mills (Avenida). Tested in Phase I.
PIC → CPW (developer reimbursement)
$34.5 million transferred from PIC to Centerra Properties West, LLC over 2008-2023. NOT substantively tested in Phase I. E&Y identified the channel via PIC check registers; the procedural scope of Phase I covered the Metro District but not PIC’s downstream developer-reimbursement payments. Phase II is the path on which that testing would have to occur. As of 17 May 2026 no public scope document for Phase II has been posted.
Metro District → McWhinney-affiliated entities
$4.9 million to McWhinney Real Estate Services (project management, park management, landscaping, event programming, maintenance, marketing, engineering, surveying). $2.7 million to CPW directly. $1.42 million to Centerra Retail Sales Fee Corporation. Water rights from seven McWhinney-related entities (CR Development, Iron Horse Development, McWhinney Holding Co LLLP, McWhinney Property Group LLC, MWater Development LLC, VDW Properties LLC, plus CPW and MRES) at undocumented price-versus-market analysis. Tested in Phase I.
Source: Ernst & Young Phase I deliverable (LURA Final Report, 3 Nov 2025, 55 pages) — Section 3.1 Flow of Funds Analysis, Section 6.1 Related-Party Observations; local archive /docs/pdf/LURA_EY_Final_Report.pdf

The most consequential single sentence in the audit appears in Section 6.1: the $34.5M PIC-to-CPW path was identified, scoped out of Phase I, and flagged for Phase II. Phase II has not been authorized.

Procedural prior — McWhinney v. City of Loveland (2023CV30956)

The audit is not the city’s first attempt to claw back the Centerra financial arrangement. In November 2023 a newly-seated council under Mayor Jackie Marsh voted to rescind the Centerra South URA and the underlying MFA. McWhinney Real Estate Services sued in Larimer County District Court eight days later, requesting a temporary restraining order. The TRO was denied; an unopposed preliminary injunction was approved 14 December 2023, ordering the city not to implement the rescission. Three months later the council reversed itself, voted to restore the rescinded URA and MFA, and entered settlement talks. The case settled on 27 July 2024.15

Case
McWhinney Real Estate Services Inc. et al. v. City of Loveland, 2023CV30956 (Larimer Co. District Court)
Plaintiff counsel
Brownstein Hyatt Farber Schreck LLP (Denver)
Trial-court judge
Judge Carroll Michelle Brinegar (the same judge who later dismissed the citizen-side Jensen open-meetings suit on 21 Oct 2025) — not to be confused with either Brian G. Carroll (IA-LLP EC) or Patrick F. Carroll (IA-LLP President / GC), per the Players disambiguation; the three Carrolls are distinct individuals with no established connection.
City response
11/29/2023 special meeting hires outside counsel; 12/14/2023 unopposed preliminary injunction enters; 02/21/2024 council reverses and restores the URA; 03/21/2024 council formally votes to settle; 07/27/2024 settlement reached.
Project shielded by settlement
140-acre Centerra South mixed-use development; project value reported ~$1 billion; $155M in TIF financing; Whole Foods anchor; ~1,000 residential units; the same 1.25%-of-3¢ / 25-year sales-tax-share structure later replicated in the 17 February 2026 Costco BAA.
Sources: Reporter-Herald 21 Feb 2024 (URA restoration); BizWest 15 Dec 2023 (injunction); Complete Colorado 28 Nov 2023 (filing); Coloradoan 27 Jul 2024 (settlement headline); KFKA appellate-reversal coverage; FOIC summary of the parallel Jensen dismissal

The McFall council that approved the 2026 BAA is the second Loveland council seated since the Marsh-era rescission attempt was reversed. By that point the city had already paid the legal cost of losing — outside counsel for the injunction defense, the political cost of the reversal vote, and an unrecovered fee award the settlement terms have not been published in sufficient detail to quantify. The 8-1 vote on Parcel 504 reflects an ideological-coalition reset since 2023 as well as a developer that has shown it will and can sue to enforce the MFA structure if the city tries to unwind it.

The McWhinney → Realberry rebrand (12 January 2026)

Three months after E&Y delivered Phase I, the developer changed its name. Articles of Amendment filed with the Colorado Secretary of State on 9 January 2026 (effective 12 January) renamed McWhinney Real Estate Services, LLC (CO entity 19941074917, formed 1994) to Realberry Real Estate Services, LLC4 . The filing was prepared by Lori Argall at Holland & Hart LLP in Reno, Nevada.

The company’s public framing was that the rebrand “honors where we began” — co-founder Chad McWhinney referenced the McWhinney brothers' original 1980s berry stands in Southern California — while “expanding who we serve” to accredited investors nationally through a new technology-driven investment platform5 . Five weeks later the renamed entity returned to Loveland City Council asking for the largest single business-assistance package in city history.

Adjacent record — Chad McWhinney named in 2014 Epstein document production

Chad McWhinney’s name appears in a single redacted document produced under the “EFTA” Bates prefix that is typical of the Estate of Jeffrey Epstein civil-discovery productions. The document, Bates number EFTA01203131, is a one-page email dated 1 November 2014. Both the sender’s name and the recipient’s last name are redacted; the recipient first name is shown as “Jeffrey.” The body text, in full:

Document
One-page email exhibit · Bates EFTA01203131
Date
Saturday, 1 November 2014, 23:44 UTC
From / To
From: [redacted] · To: “Jeffrey” [redacted]
Body text
“chad mcwhinney, kimball’s friend). — I like him a lot. Seems like a very nice and solid person. Took him to Mark for lunch. — Sent from my iPhone.”
Inline image
IMG_4969.JPG · appears to show a man in a dark shirt at a restaurant setting; the second person in the photo is fully redacted with a black bar
Local archive
EFTA01203131.pdf · preserved verbatim, no edits to the produced document
Source: Estate of Jeffrey Epstein document production · Bates EFTA01203131 · provided 2026-05-16

What this document does and does not show, strictly:

It is included here because Chad McWhinney is the named co-founder and current CEO of Realberry (formerly McWhinney Real Estate Services), the entity at the center of the Centerra urban-renewal plan analysed above, and is a public-figure principal of the entity that received the Costco BAA on 17 February 2026. This dossier’s standing position — that no personal criminal conduct is alleged — is unchanged9 .

The document itself, inline:

PRIMARY DOCUMENT · INLINE EFTA01203131 · email exhibit · 1 Nov 2014
First-page render of The full one-page exhibit as produced. Sender name redacted; recipient first name 'Jeffrey,' last name redacted. Inline JPG shows a man at a restaurant; second person in the frame fully redacted with a black bar. — click to open the full PDF.

Your browser declined to embed the PDF inline. Above is a first-page render; open the full document (1 page) for the complete record.

Bates EFTA01203131 1 page open in new tab ↗ The full one-page exhibit as produced. Sender name redacted; recipient first name 'Jeffrey,' last name redacted. Inline JPG shows a man at a restaurant; second person in the frame fully redacted with a black bar.

Adjacent record — landlord-tenant and geographic proximity to Kimbal Musk

The single redacted email above is the only document in the produced corpus that names McWhinney by name. The wider context — what the press has covered and what the public records show — places the McWhinney family and Kimbal Musk inside one small Denver LoDo developer-and-restaurant network in the 2010s. The narrowest factual picture, in primary-source terms:

Realberry / Centerra Properties West HQ address
1800 Wazee Street, Suite 200, Denver CO 80202 (per Colorado Secretary of State filings, current).
Kimbal Musk’s The Kitchen American Bistro
1560 Wazee Street, Denver CO 80202 — the original 2004 location of The Kitchen Restaurant Group, two blocks south of Realberry’s office on the same street.
Denver Union Station development
Co-developed by McWhinney via the Union Station Neighborhood Company joint venture with East West Partners and Continuum Partners. The Crawford Hotel inside Union Station maintains a public event space named the “McWhinney Room.”
The Kitchen Next Door — Denver Union Station
1701 Wynkoop Street, Suite 100, Denver CO 80202 — operated by Kimbal Musk’s The Kitchen Restaurant Group inside the Union Station / Crawford Hotel complex; closed circa 2023 when Musk stepped away from the Next Door / streetBar concepts.
Counsel’s public denial, in full text
McWhinney’s attorney Chris Murray (Feb 2026) — not to be confused with Tyler Murray of Cushman & Wakefield Fort Collins (the listing broker on 599 W 71st), per the Players disambiguation; Chris Murray’s firm affiliation has not been confirmed from primary records but is potentially Brownstein Hyatt Farber Schreck per the 2023CV30956 docket — denied that McWhinney met Epstein, corresponded with Epstein, did business with Epstein, or knew the redacted-sender woman had Epstein ties. The Denver Post (12 Feb 2026) noted in print that the same statement did not address “the relationship between McWhinney and Kimbal Musk and whether they are still friends.”
Sources: Denver Post 2026-02-12 (Noelle Phillips); Boulder Reporting Lab 2026-02-11 (Musk-only investigation); BizWest 2026-01-15 (McWhinney’s LinkedIn “Behind the Blueprint: Denver Union Station”); Crawford Hotel public booking page (“McWhinney Room”); local archives /docs/html/denverpost_epstein.html, /docs/html/brl_kimbal.html, /docs/html/mcwhinney_us_post.html

What this is and is not. It is a documented social-and-commercial network adjacency between two Front Range principals operating two blocks apart on Wazee Street in 2014, with a public landlord-tenant relationship at Denver Union Station, where one is a redacted-sender introducer who appears in the Epstein corpus separately for unrelated reasons, and the other is named in a single third-party email in that same corpus. It is not evidence that the two were business partners, that they invested in each other’s ventures, or that either crossed paths with Jeffrey Epstein directly. None of those things appears in the produced documents.

The supporting CO SOS filings, inline

The 2026 rebrand from McWhinney to Realberry — and the underlying 1994 formation document showing the entity’s full filing history — are both preserved verbatim:

PRIMARY DOCUMENT · INLINE Articles of Amendment — McWhinney Real Estate Services LLC → Realberry Real Estate Services LLC

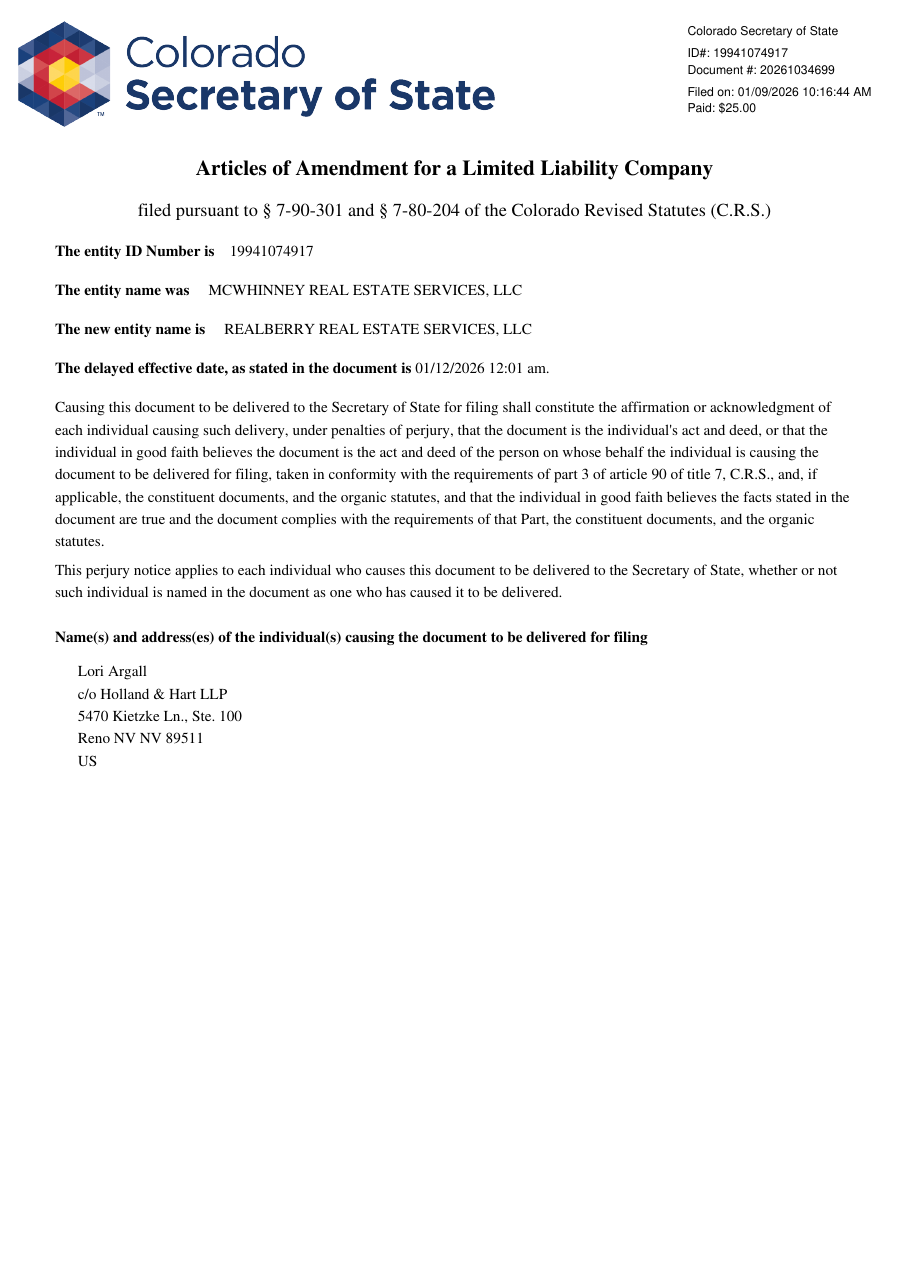

First-page render of Filed 9 January 2026, delayed effective 12 January 2026 12:01am. Filing prepared by Lori Argall c/o Holland & Hart LLP, 5470 Kietzke Ln Ste 100, Reno NV 89511. CO SOS document 20261034699. — click to open the full PDF.

Your browser declined to embed the PDF inline. Above is a first-page render; open the full document (1 page) for the complete record.

Bates CO SOS 20261034699 1 page open in new tab ↗ Filed 9 January 2026, delayed effective 12 January 2026 12:01am. Filing prepared by Lori Argall c/o Holland & Hart LLP, 5470 Kietzke Ln Ste 100, Reno NV 89511. CO SOS document 20261034699.

R-10-2026 — the Costco Business Assistance Agreement

Resolution
R-10-2026 · passed 17 February 2026, 8-1 (Rothberg dissenting)6
Developer (named in resolution)
Centerra Properties West, LLC · the McWhinney-affiliated entity7
Property
Parcel 504 · 83.31 acres at the northeast corner of US 34 and Centerra Parkway · within Centerra Metropolitan District No. 1
Project
≈400,000 sq ft commercial development in two phases, anchored by a 160,000 sq ft Costco warehouse store, with ≈300 jobs
Total infrastructure cost
≈ $42 million
City sales-tax rebate
1.25 of 3 cents on new Costco sales for 25 years, capped at $25 million (or certificate-of-occupancy +25 years, whichever first) — bond-proceeds OR 25-year PIF rebate cap
City cash contribution (Kendall Parkway)
$11 million net city cash · Realberry contributes $2M of the $13M
Developer reimbursement (aggregate)
$6.5 million aggregate developer reimbursement ($300K/yr × ~22 yrs)
Developer commitments
Sell 18.75 acres to Costco at nominal cost + build 850-space parking lot + dry utilities (electric, gas, broadband) · ≈ $10.6 million private spend
Projected city revenue (AIR-102809 staff packet)
“Over $100MM” over 25 years from the retained 1.75-cent share of Costco sales tax (contingent on a Costco sales-volume counterfactual) · plus ≈$68K property tax, ≈$78K fuel tax, ≈$3M one-time permit fees
Anticipated opening
early 2028
Closed-session negotiation
City Council executive sessions on 19 August 2025 and 27 January 2026 received “proprietary and confidential business information”7
Source: R-10-2026 staff report (CivicWeb doc 503571, p. 134-138) + Reporter-Herald 18 Feb 2026

The official voting record for that meeting, inline — confirming the 8-1 roll-call on Item 8.1 (R-10-2026 Parcel 504 Business Assistance Agreement):

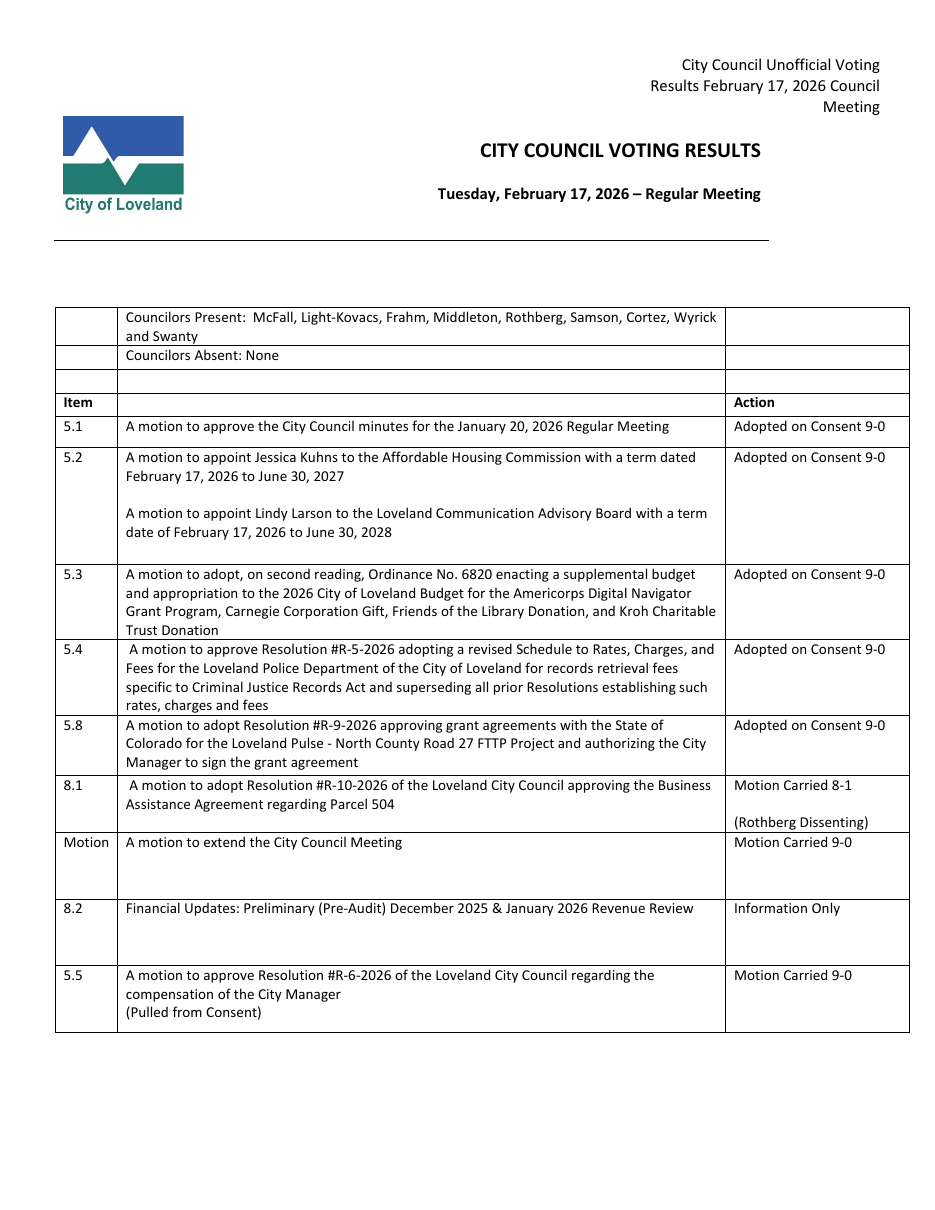

PRIMARY DOCUMENT · INLINE City Council Voting Results — 17 February 2026
First-page render of Loveland City Council unofficial voting results for the 17 Feb 2026 regular meeting. Item 8.1 (R-10-2026, Parcel 504 BAA) shows 'Motion Carried 8-1 (Rothberg Dissenting)'. — click to open the full PDF.

Your browser declined to embed the PDF inline. Above is a first-page render; open the full document (3 pages) for the complete record.

Bates CivicWeb 503860 3 pages open in new tab ↗ Loveland City Council unofficial voting results for the 17 Feb 2026 regular meeting. Item 8.1 (R-10-2026, Parcel 504 BAA) shows 'Motion Carried 8-1 (Rothberg Dissenting)'.

R-10-2026 financial-component buildup

Earlier framing of the BAA as a “$125 million tax rebate” conflated the OUTFLOW components (identifiable contractual city commitments) with the INFLOW projection (city revenue retained over 25 years from the un-rebated 1.75-cent share of Costco sales tax). The $125 million figure does not appear as a single line item in R-10-2026 itself. The components are:

ComponentAmountDirectionFact card
Bond-proceeds OR 25-year PIF rebate cap (whichever first)$25,000,000OUT (to developer over 25 yrs)facts/f3b + facts/f3c
Kendall Parkway construction (net city cash)$11,000,000OUTfacts/f3a
Aggregate developer reimbursement ($300K/yr × 22 yrs)$6,500,000OUTfacts/f3d
Subtotal — identifiable contractual city commitments≈ $42,500,000OUTfacts/f3e
AIR-102809 staff-packet projection (retained 1.75-cent share)≈ $100,000,000IN (to city, over 25 yrs)facts/f3e
Source: R-10-2026 staff report + AIR-102809 packet (CivicWeb doc 503571, p. 134-138 + p. 91 “$100MM over 25 years”); fact card `facts/f3e` for full reconciliation.

The projected revenue-into-city figure is contingent on a Costco sales-volume counterfactual (i.e. sales that would not have occurred in Loveland but for the project), and the foregone-revenue calculation varies with that counterfactual assumption. The dossier names the identifiable contractual components ($42.5M ceiling on out-flow over 25 years) and the AIR-102809 inflow projection (~$100M over 25 years) separately; the “$125M” headline is the buildup of both directions and is documented in facts/f3e for transparency.

Rothberg dissent

Ward 2 Councilor Sarah Rothberg cast the lone “no” vote, stating:

What I would really like to see happen here is developers develop the land, sells the land and the business comes in, builds it out. Then the city has sales tax all to themselves and can provide that infrastructure support and maintenance and build out. I think that kind of system has a lot of trust with community members.8

Public-comment objection

During the public-comment period of the same meeting, Ward 2 resident Megan Eliezer told Council:

There is no faith in this developer whatsoever, and to continue to give them our tax money is obscene. It is just obscene, especially when we are at a budget shortfall that we keep hearing about. It’s not the grocery tax that’s the problem. Giving money to developers is the problem.8

A second Ward 2 resident, Gail Randall, was cut off by Mayor McFall when she invoked the Ernst & Young audit during her three-minute remarks. Her First Amendment lawsuit, filed three days later, is the subject of Chapter 07 · Recall.

What the timing means

Compressed into a six-month window, the documented sequence is:

The Centerra URA’s own master agreement was the document Mayor McFall declared off-topic when a resident tried to read its audit findings into the public record of the city’s largest new financial commitment to the same developer.

Primary Sources

  1. 1 press Centerra audit finds bidding, accounting lapses in Loveland, Loveland Reporter-Herald,
  2. 2 press Loveland council to vote on Centerra audit, Krenning recall, Loveland Reporter-Herald,
  3. 3 press Ernst & Young partner Gary Burke remarks to LURA board, 14 Oct 2025 — reported in Reporter-Herald, Loveland Reporter-Herald,
  4. 4 registry Articles of Amendment — McWhinney Real Estate Services LLC → Realberry Real Estate Services LLC (Doc 20261034699), Colorado Secretary of State, [local archive]
  5. 5 press McWhinney rebrands as Realberry, expands investment approach, BizWest,
  6. 6 filing City Council Voting Results — 17 February 2026 (R-10-2026 8-1), City of Loveland · CivicWeb, [local archive]
  7. 7 filing LOVELAND CITY COUNCIL MEETING — 17 Feb 2026 — Agenda (R-10-2026 staff report at p. 134-138, full BAA text follows), City of Loveland · CivicWeb, [local archive]
  8. 8 press Costco coming to Loveland after City Council vote, Loveland Reporter-Herald,
  9. 9 court Email exhibit mentioning Chad McWhinney · Bates EFTA01203131 · 1 Nov 2014, Estate of Jeffrey Epstein document production (civil discovery), accessed
  10. 10 press Costco coming to Loveland after City Council vote (identifies Jeff Breidenbach as Realberry NoCo Development Director presenting the BAA to council), Loveland Reporter-Herald,
  11. 11 filing LURA Board Packet — 14 October 2025 — embeds the full Ernst & Young Phase I observations-and-recommendations slide deck (pages 47-87): three workstreams (Procurement, Related-Party, Disbursement), sample of 73 cash disbursements + 9 public bid awards examined, MFA sections 6.3 / 8.1-8.3 / Exhibit L referenced, Loveland Urban Renewal Authority · CivicWeb, [local archive]accessed
  12. 16 filing LURA Board Packet — 12 August 2025 — Centerra North E&Y audit scope, Phase I work-in-progress, request timeline (Feb 12 / Feb 26 / Jun 20 / Oct 1 deliverable phases), Loveland Urban Renewal Authority · CivicWeb, [local archive]accessed
  13. 17 filing LURA Board Packet — 11 February 2025 — E&Y engagement initial scope and contract, Loveland Urban Renewal Authority · CivicWeb, [local archive]accessed
  14. 18 filing LURA Board Packet — 8 April 2025 — E&Y interim progress, sample design, Loveland Urban Renewal Authority · CivicWeb, [local archive]accessed
  15. 19 filing LURA Board Packet — 9 December 2025 — Phase II scope-of-work discussion (cost estimates and detailed workstreams for suspected violations), Loveland Urban Renewal Authority · CivicWeb, [local archive]accessed
  16. 20 filing LURA Board Packet — 22 January 2026 — post-Phase-I board actions and resolutions, Loveland Urban Renewal Authority · CivicWeb, [local archive]accessed
  17. 21 registry Strong Colorado IEC (Reg ID 20245047480) — registered 26 Jun 2024, agent Marge Klein (Polifi LLC), purpose: support conservative candidates; financial summary captured 17 May 2026, Colorado Secretary of State · TRACER, [local archive]accessed
  18. 22 registry NoCo Reboot IEC (Reg ID 20195037700) — committee detail page (TRACER), Colorado Secretary of State · TRACER [local archive]accessed
  19. 23 registry Justice for Jason IEC (Reg ID 20245046974) — committee detail page (TRACER), Colorado Secretary of State · TRACER [local archive]accessed
  20. 24 filing Loveland FY 2026 Budget Book — Law Enforcement Capital Expansion Fee (CEF) Fund 265 — shows $575K adopted → $3.84M revised in 2025 (Operations $3.04M / Administration $798K; by class: Supplies $1.7M, Capital Outlay $1.37M, Transfers $766,839 — destination not disclosed on public summary), City of Loveland · OpenGov [local archive]accessed
  21. 12 filing Centerra MD No. 1 — Regular Meeting Agendas (15 Jan + 19 Feb 2026) — work-order ratifications + Parcel 504 financing exec session, Centerra Metropolitan District No. 1, accessed
  22. 13 press Pinnacle Consulting Group, Inc. — About / Team — 100+ Title 32 districts, $780M bond portfolio, $80M+ capital projects, Pinnacle Consulting Group, Inc.accessed
  23. 14 filing Centerra MD Nos. 1-5 — 2025 Annual Report — 16 Oct 2025 board meeting attendance record, Centerra Metropolitan District No. 1, accessed
  24. 14.5 filing LURA Agenda Packet — 12 Aug 2025 (92 pp, 9.4 MB) — 5.1 Brian Waldes 2025 financial overview + 2026 budget preview (URA-by-URA detail, sunset projections, Cost-of-Service Study); 5.2 LURA Attorney + Ernst & Young Aug 12 interim update presentation, City of Loveland · CivicWeb · LURA, accessed
  25. 14.6 filing LURA Agenda Packet — 9 Dec 2025 (89 pp, 7.4 MB) — embeds the full Ernst & Young Final Forensic Report (cover letter 3 Nov 2025); §3.1 Flow of Funds documents $34.5M PIC → CPW 2008-2023; §4 procurement recommends pre-2015 expansion ($18.4M) and review of 37 remaining contracts and CPW-side procurement; §6.1 documents no recusal record since MFA inception. Includes Oct 14 minutes with Burke confirming the $249K engagement budget was exceeded., City of Loveland · CivicWeb · LURA, accessed
  26. 15 court McWhinney v. City of Loveland (2023CV30956) — TRO denial 30 Nov 2023, unopposed preliminary injunction 14 Dec 2023, council reversal 21 Feb 2024, settlement 27 Jul 2024, Loveland Reporter-Herald / BizWest / Complete Colorado / Coloradoan (compiled), accessed
